Caution Updated:

  • New! City-wide Stage 4 outdoor water restrictions are in effect and indoor water conservation is needed while crews connect the new Bearspaw South Feeder Main to the existing water system. Learn more about water restrictions

Mckenzie Sanitary Siphon Upgrade

Critical upgrades to ensure resilient and efficient wastewater transportation Mckenzie Sanitary Siphon Upgrade

Project status

Site Access and Pathway Closures

Construction crews are beginning work on a section of the McKenzie Sanitary Siphon Upgrade, a project that will improve the reliability and capacity of Calgary's wastewater system.

Work includes constructing a temporary access route, installing new sanitary infrastructure, and completing site restoration activities. Construction will take place in and around the pathway network between the Mountain Park Drive SE and the Bow River Pathway, including areas near Mt. Belcher Place SE and Mt. Cascade Place SE.

Residents can expect temporary pathway closures and signed detours throughout the Mountain Park community. Temporary pathway connections will be provided where possible, and sections of the Bow River Pathway may periodically reopen depending on construction activities and site conditions.

Construction is expected to continue through November 2027. Please visit the project page regularly for the latest information on construction activities, project progress, and upcoming work.

Construction Schedule

Construction is scheduled in phases from November 2026 to November 2027.

Phase 1 - November 6 to November 20, 2026
Construction activities include:

  • Pathway closures
  • Detours
  • Temporary access route construction

Phase 2 - November 2026 to November 2027
Ongoing construction activities include:

  • Access road construction down the escarpment
  • Microtunnel construction activities
  • Sanitary pipe and chamber installation
  • Site reclamation and restoration activities

Project background

The McKenzie Sanitary Siphon consists of an inlet chamber and two underground pipes that conveys wastewater flow beneath the river and through Fish Creek Provincial Park that help transport wastewater to the Fish Creek Wastewater Treatment Plant for treatment. The Siphon is a critical component of the wastewater system, allowing wastewater from upstream communities to cross the river without interruption and preventing sewer backup in homes, businesses, and infrastructure.

The system was built in 1980 and now requires upgrades which will enhance the system’s reliability and capacity to prevent sewage backups during heavy rainfall events.

Construction is anticipated to begin in summer 2026 and is expected to be completed in fall 2027. Most of the upgrade work involves trench excavation to install two new sanitary pipes. Microtunnelling will be used to install the siphon pipes under the river.

This project is separate from the Fish Creek Wastewater Plant Upgrade project, but will contribute to efficiently transporting wastewater to the plant.

Project benefits

  • Provides resiliency to our wastewater system through installing these new pipes and using the existing pipes as redundancy. This means if the new pipes become inoperable due to an emergency, the existing pipes can be temporarily brought back into service so wastewater can continue to flow to the treatment plant.
  • Adds capacity to the wastewater system to address current and future population growth.
  • Ensures wastewater flows freely to the treatment plant where it is cleaned  before releasing into the river, preventing backups in high-flow conditions.

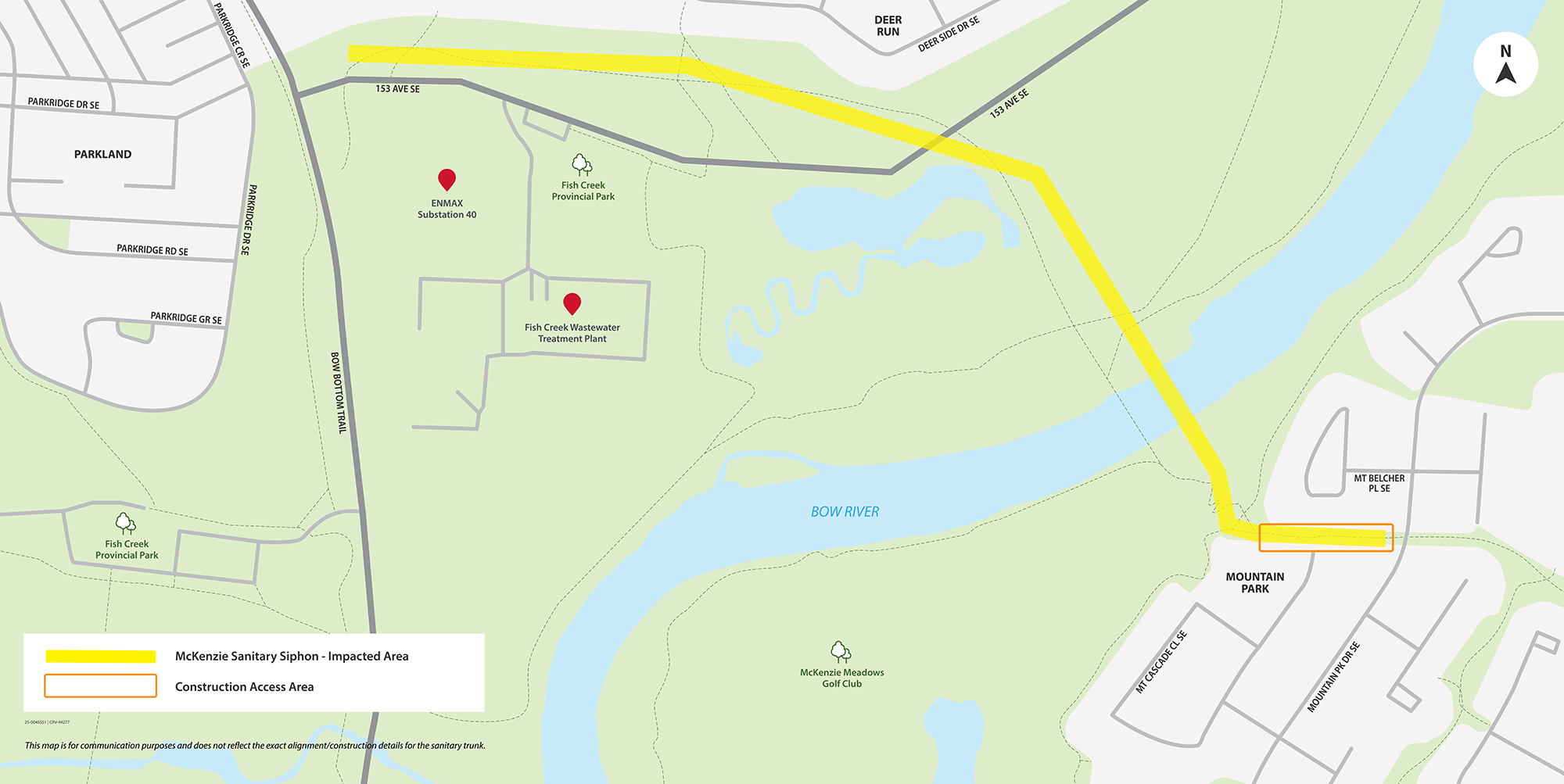

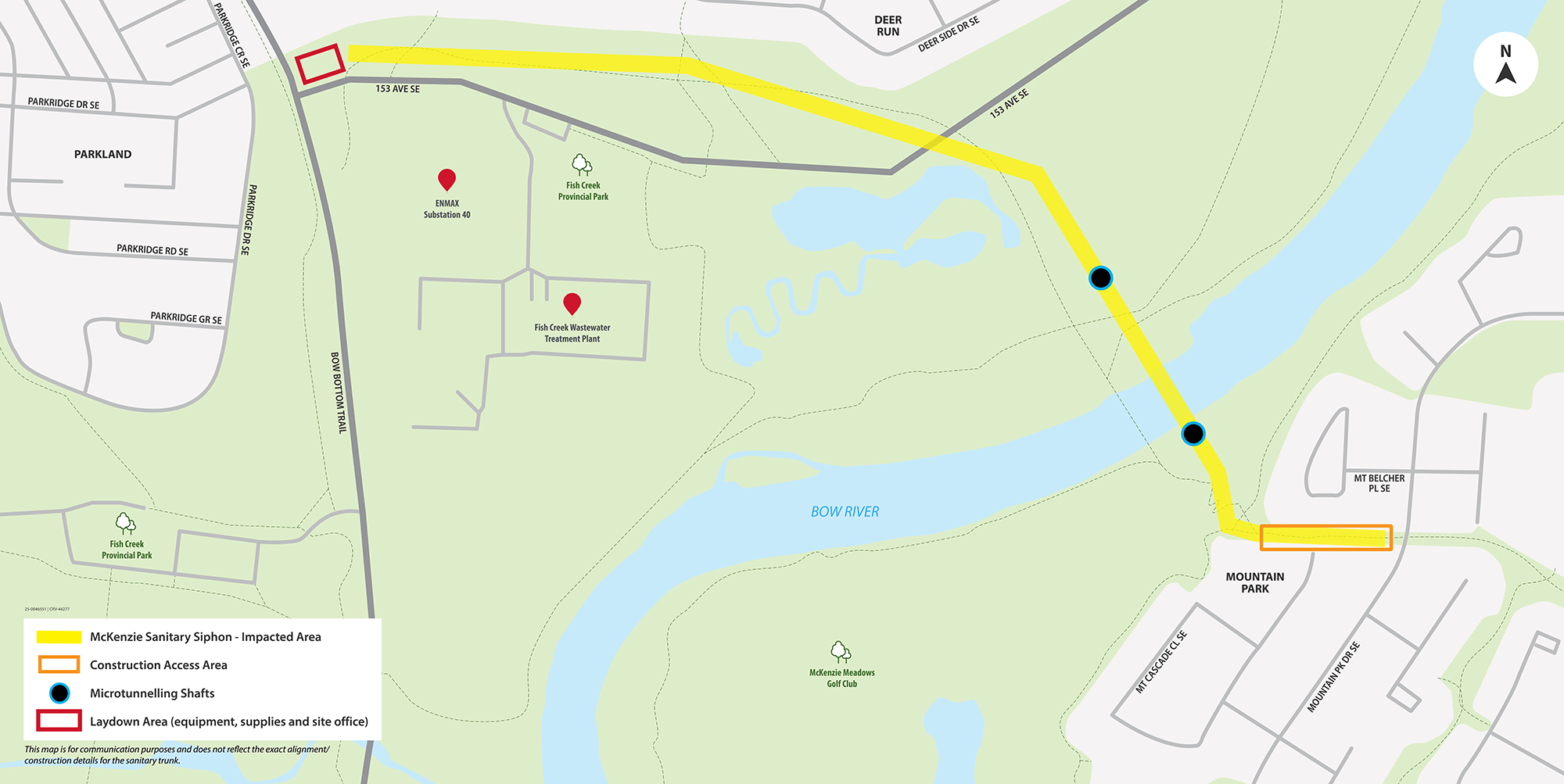

Project map

Click image to enlarge.

Construction route maps

Project timeline

  • Hydrovac work: August 31 to September 6, 2026
  • Mobilize to site on west side of river: mid - September 2026
  • Mobilize to site on east side of river: mid - September 2026
  • Microtunnelling construction: September 2026 to March 2027
  • Open cut construction on west of river: October 2026 to April 2027
  • Open cut construction east of river: May 2027 to November 2027
  • Restoration work: June 2027 to October 2027

Stay connected

Connect with the project team

For more information, please contact the project team

Related project

Frequently Asked Questions

What is the construction timeline?

We are planning to begin construction in summer 2026 and it will last until fall 2027. These dates are subject to change based on weather, supply of materials and other factors.

Will there be any pathways/roads closed?

There will be pathway closures of the Bow River Pathway on the east side of the Bow River near the community of Mckenzie Lake.  Detours and/or temporary pathways will be provided to pathway users.  More details will be provided at a later date. Additionally, 153 Avenue, which is the road entering Fish Creek Provincial Park, will be temporarily closed at some point during construction.

How will construction impacts and progress be communicated to nearby residents and businesses?

Prior to and during construction, residents and businesses will be notified through delivered Construction Notices which will include information on impacts, timelines and status of the project. This project website will also be regularly updated.

Will the current siphon still be used after the new pipes are installed?

Yes,  the old pipes will be used only in emergency situations if there is an issue with the new pipes.

What is the pipe material made out of?

A section of the pipe is made of PVC which will be installed underground on land while  another section is made of steel, which will be used under the Bow River.
