Bearspaw South Feeder Main replacement project
Overview
The City is implementing a revised plan that urgently expedites construction of a replacement for the Bearspaw South Feeder Main (BSFM) due to the critical condition of the current pipe and its importance in Calgary’s drinking water system.
The project is adding a parallel steel pipe of the same size as the existing BSFM. Over time, this new pipe will take over service from the current line. The replacement pipe is anticipated to be completed in December 2026.
This work is an important investment in water infrastructure to support system reliability and reduce the risk of feeder main issues or failures.
Project stages
The project is happening in two stages:
- Stage A: From the Shaganappi Pump Station to 73 Street N.W. on the west side of the Bow River.
- Stage B: Continues from 73 Street N.W. to 89 Street N.W., with a potential extension to the Bearspaw Water Treatment Plant.
2026 Bearspaw South Feeder Main Replacement Stages A & B
Contact
If you have questions or feedback about the project, we’d like to hear from you.
- Email: BSFMProject@calgary.ca
- Complete the Resident contact information form
- Call 311
Stage A construction
Construction for Stage A of the new Bearspaw South Feeder Main began in January using microtunnelling. This stage of the project will run from the Shaganappi Pump Station to 73 Street N.W., on the west side of the Bow River.
This approach was chosen because the pipe alignment includes significant crossings such as 16 Avenue, the Bow River and the CPKC rail line. While some surface work will still be required, work is largely happening at targeted locations instead of along the entire corridor.
Stage A project status
Project status as of July 22, 2026:

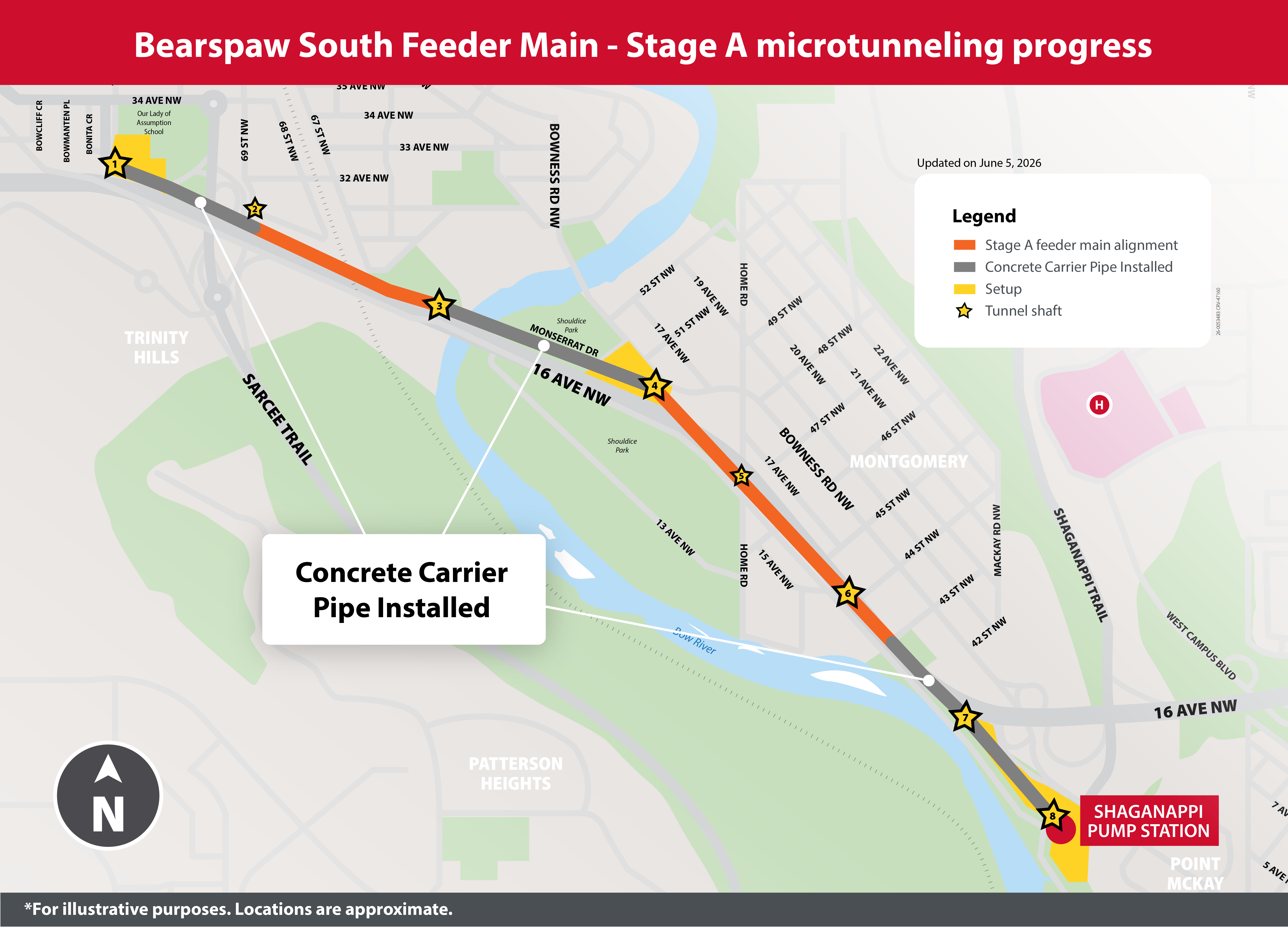

- Stage A, microtunneling construction is progressing on schedule.
- Crews are nearing completion of the microtunneling and installation of the concrete carrier pipe, which will enclose the new steel feeder main. This phase of work is expected to be completed within the next month.
- To date, more than 1100 meters of steel feeder main have been installed inside the concrete carrier pipe across Stage A, between the Shaganappi Pump Station and 73 Street N.W.
- Additional construction to support Stage A continues to progress on track, including:
- Microtunneling shaft construction on 16 Avenue N.W. at 44 Street N.W.
- Microtunneling shaft construction near Sarcee Trail N.W. on 29 Avenue N.W.
Image gallery
Microtunneling shaft under construction on February 27, 2026. This shaft will be used to microtunnel Stage A of the new Bearspaw South Feeder Main.
Stage A of the Bearspaw South Feeder Main replacement project is being completed using microtunneling. This image shows the construction of a microtunneling shaft beside 16 Avenue N.W. at Edworthy Park on February 27, 2026.
Construction of microtunneling shafts for Stage A of the Bearspaw South Feeder Main replacement project is underway. This image from February 27, 2026, shows progress on a microtunneling shaft at Edworthy Park next to 16 Avenue N.W.
Image from March 12, 2026, shows construction progress on the Bearspaw South Feeder Main Stage A microtunneling shaft beside 16 Avenue N.W. just east of the exit to 29 Avenue N.W.
Stage A of the Bearspaw South Feeder Main replacement project will be completed using microtunneling. This image from March 12, 2026, shows construction progress on a microtunneling shaft along 16 Avenue N.W.
Stage B construction
Stage B construction for the Bearspaw South Feeder Main replacement project started May 11, 2026, and is expected to continue through November 2026. The new replacement pipe will run from 73 Street N.W. to 89 Street N.W., where it will connect to the existing steel pipe leading to the Bearspaw Water Treatment Plant. Extending the pipe to 89 Street N.W. helps avoid future construction and reduces future community disruptions.
Work started with cross-connection construction the week of May 11 at 77 Street N.W. and 83 Street N.W., and we are now installing the new steel feeder main along 34 Avenue N.W.

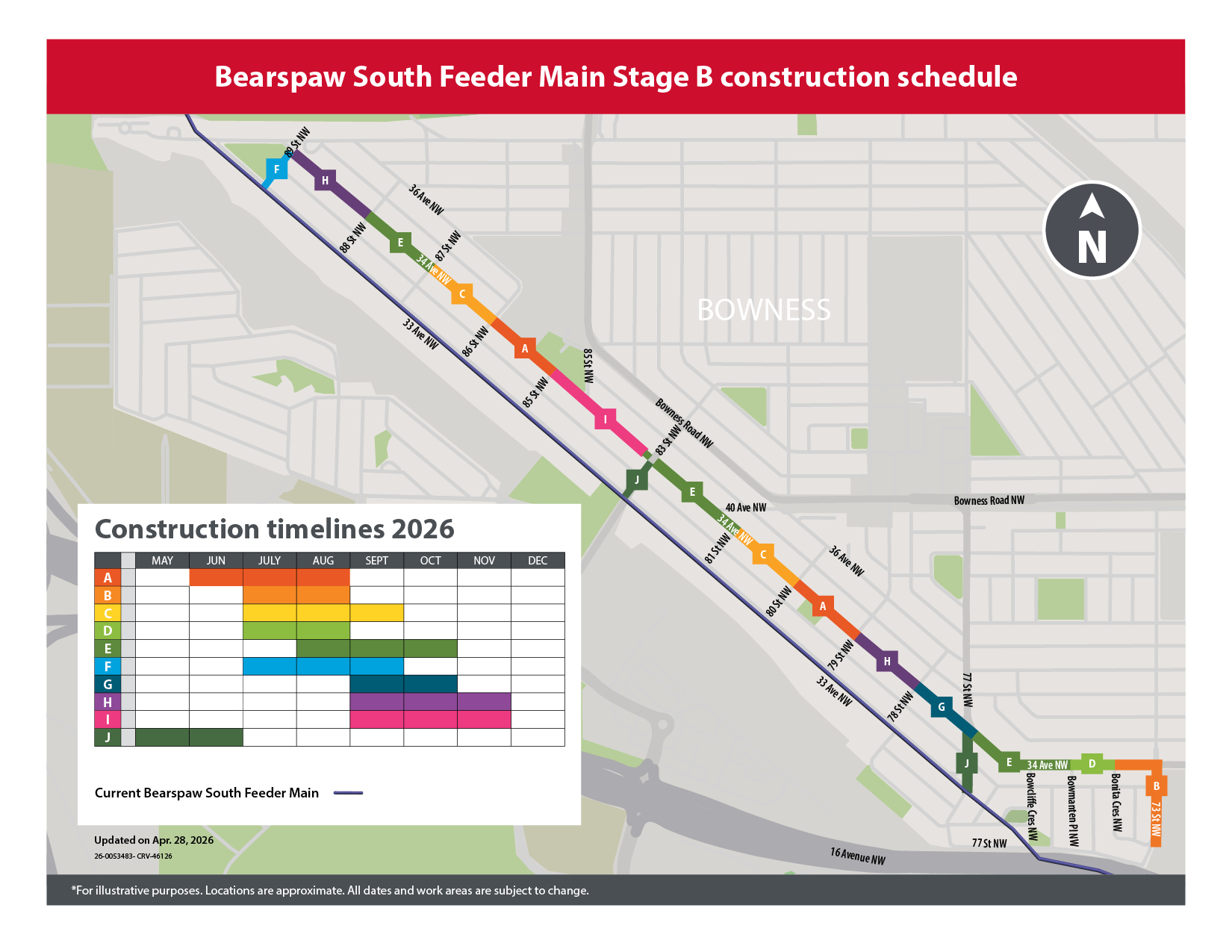

Stage B is being installed using an open‑cut construction approach, which allows work to be completed more efficiently and shortens the overall construction timeline. Construction is being completed in sections, with crews generally working east to west along 34 Avenue N.W. Multiple crews are active at the same time, and each work area is expected to take approximately 10 to 12 weeks to complete.
Stage B project status
Project status as of July 22, 2026
- Stage B feeder main construction began in June and there are now 40 segments of the new steel feeder main installed along 3 blocks on 34 Avenue N.W. in Bowness.
- Work is being completed using an open-cut approach, advancing in sections along 34 Avenue N.W., with multiple crews active at the same, allowing roads, sidewalks and property access to be restored as construction moves through the area.
- With the first installations complete, access to affected blocks will be restored.
- Construction will continue along 34 Avenue N.W. until the end of year as crews install steel feeder main pipe, complete utility work and restore affected areas once work is finished.
Stage B open-cut construction on 34 Avenue N.W., July 10, 2026
Steel pipe being delivered and installed for Stage B of the Bearspaw South Feeder Main replacement project.
Steel pipe being delivered and installed for Stage B of the Bearspaw South Feeder Main replacement project.
Steel pipe being delivered and installed for Stage B of the Bearspaw South Feeder Main replacement project.
July 28, 2026, images shows open cut construction and steel feeder main installation in Bowness on 34 Avenue N.W.
July 28, 2026, images shows open cut construction and steel feeder main installation in Bowness on 34 Avenue N.W.
Stage B construction process
- Crews will be excavating within the public right-of-way to install utilities for the replacement feeder main. This work will be done using an open-cut method.
- Step 1: Pre-construction work such as tree pruning/removal and signage removal.
- Step 2: Road will be closed, fencing will be put up, detours will be put in-place.
- Step 3: Asphalt cutting will begin to remove surface materials.
- Step 4: Excavation to reveal existing utilities and dig out pipe trench.
- Step 5: Relocation and Installation of new utilities
- Step 6: Backfill & paving
- Step 7: Community restoration
What to expect
- Crews will be working Monday - Saturday 6:30a.m. – 9p.m, Sunday as required. These hours have shifted and may change again, subject to project schedule needs.
- Construction vehicles around work areas.
- Traffic impacts and detours. Temporary street parking impacts.
- When construction begins in a specific area, that entire area will be closed to traffic and parking.
- Driveway access may be impacted for some residents. City representatives will be reaching out to impacted property owners directly.
- Fenced areas for equipment and supplies.
- Noise, dust and vibrations.
- There are NO planned water, gas, or electric outages, but temporary shutoffs may be required.
Potential tree & property impacts
During Stage B construction, some trees and shrubs in and near the public right‑of‑way may be affected.
The public right‑of‑way often extends beyond the paved road and can include areas that look like part of a private yard. Ahead of construction, our team conducted a detailed inventory and health assessment of all trees and shrubs within the public right‑of‑way, including those nearby or overhanging into the right-of-way.
What to expect
- Tree pruning may be needed where branches extend into the public right‑of‑way.
- All trimming and removals will be completed only when needed and as construction moves from one work area to the next. This approach helps minimize unnecessary impacts.
How work will be done
- If a tree on or near your property is impacted, a member of our team will contact you directly.
- All tree work will be carried out by qualified City arborists or professional tree removal contractors.
- All landscaping restorations are covered by a two‑year warranty (two growing seasons).
Sidewalk Improvements on 34 Avenue
As part of the Bearspaw South Feeder Main (BSFM) replacement project, sidewalks along 34 Avenue N.W. between 73 Street and 89 Street will be widened from 1.2 metres to 1.5 metres. The wider sidewalks will improve accessibility and pedestrian safety while aligning with the standards used in newer communities. A short section between 73 Street and 77 Street will remain at its current 1.2-metre width to maintain consistency with the sidewalk on the opposite side of the street, which is not being reconstructed as part of this project.
The sidewalk improvements will be accommodated within the existing public right-of-way and will not reduce roadway width or affect vehicle travel lanes. While every effort will be made to minimize impacts, some residents may experience temporary changes within the public right-of-way adjacent to their property, including the relocation of street lights, additional trimming of trees and shrubs, or impacts to privately installed irrigation systems and landscaping located within the public right-of-way. Project team members will contact affected residents directly to discuss any anticipated impacts before construction begins.
Feeder main construction
*Please note there have been changes to the previously communicated construction schedule:
- Construction on 34 Avenue N.W. between 73 Street N.W. and Bowcliffe Crescent N.W. has been rescheduled for August 4. When that work is complete crews will continue west between Bowcliffe Crescent N.W. and 77 Street N.W.
- Planned construction on 73 Street N.W. to Bonita Crescent N.W., originally scheduled to begin July 1, has been postponed. A revised start date will be shared once it is confirmed.
- Residents may also notice activity at the green space on 89 Street N.W. between 33 Avenue N.W. and 34 Avenue N.W., which is now being used as a construction laydown and pipe storage area. To support this work, street parking is not permitted along this block of 89 Street N.W. The area will be fenced and is expected to remain in use through project completion in December 2026. While construction activity is increasing, the basketball court and playground will remain open for community use.
