2026 paving projects

Planning for the 2026 Annual Paving Program is currently underway.

The City of Calgary’s Annual Paving Program is active between May and October (weather permitting). The 2025 Annual Paving Program is a planned service program that saw 530 lane kilometres of Calgary’s roads paved at 320 locations across the city.

Paving projects rehabilitate roads that have degraded over time due to age. By performing preventative maintenance, such as resurfacing roadways, the annual paving program helps prevent more expensive and disruptive road reconstruction work in the future.

A typical paving project is completed in several steps:

  • Paving projects are identified and scheduled in the fall/winter; this also includes working with other asset owners to ensure there are no conflicts or planned work.
  • In the spring/summer, work begins with the repair and potential upgrade of concrete around the project area (things like sidewalks, wheelchair ramps, curbs and gutters).
  • The existing road is milled, which is the removal of the top layer of asphalt.
  • Things like manhole covers on the road are adjusted to ensure even driving surface.
  • A fresh layer of pavement laid.

Work is usually scheduled during off-peak hours, evening and weekends and is weather dependent. Projects occur throughout the spring, summer, and fall.

To complete the surface overlay process the following steps are performed.

The process takes up to eight weeks to be completed.

Concrete process

Step 1 – Prep work

Paint is used to identify concrete that needs to be replaced and any underground utility locations. This is done one to eight weeks prior to excavation.

Step 2 – Excavation

Old or damaged concrete must be removed before concrete placement. This is a two or three day process.

Step 3 – Form setting and concrete placement

The forms are then setup and the concrete is poured. The concrete then sets, hardens and the forms are removed. This is over one to three days.

Step 4 – Concrete Process

It takes 24 to 48 hours for concrete to cure enough for pedestrian use. The process can take between 7 and 28 days for vehicle use.

Step 5 – Rehabilitation and seed

Broken asphalt or loam is replaced and then the seed placed. The area is cleaned up and barricades are removed. During this one to three day process, parking restrictions are required.

Paving process

Step 1 – Milling

The old pavement surface is removed one to two weeks before Step 2. Parking restrictions are in place during the milling, which takes approximately one day.

Step 2 – Adjust manholes

Manholes are raised to the same level as the new pavement which takes approximately one day.

Step 3 – Oiling

The oil is then applied to hold the pavement to make the new pavement stick, which happens 24-48 hours prior to paving.

Step 4 – Paving

A layer of new asphalt is applied. Two layers of asphalt may be required to make the pavement level with the gutter. Parking restrictions are required for the one to two day process.

2026 major road paving projects

The following paving locations are grouped by quadrant. Closure information will be displayed when work is scheduled, typically 1-2 weeks before the project work beings. Project information is also available on The City’s Roadway activities map. These projects are completed by both City forces and contracted partners.

Not all roads are currently on our project list, and community paving locations will be shared this spring.

Note: Project timelines are subject to change, including but not limited to weather, equipment, material and staffing. While we strive to ensure this information is updated and accurate, changes can occur.

Northeast projects

Location Status

12 St N.E.

  • from McKnight Blvd N.E. to 32 Ave N.E.
Planning

32 Ave N.E.

from Deerfoot Tr N.E. to 32 St S.E. (SB)

Planning

32 Ave N.E.

  • from 36 St N.E. to Barlow Trail N.E.
Planning

36 St N.E.

  • from 16 Ave N.E. to 39 Ave N.E.
Planning

Country Hills Blvd N.E.

  • from 36 St N.E. to Metis Tr N.E.
Planning

Memorial Dr N.E.

  • from 36 St N.E. to Marlborough Way N.E.
Planning

Northwest projects

Location Status

53 St N.W.

  • from John Laurie Blvd N.W. to Crowchild Trail N.W. ramp

Planning

Beddington Blvd N.W.

  • from Sandstone Hl N.W. to Centre St N.

Planning

Berkshire Blvd N.W.

  • from Beddington Tr N.W. to 14 St N.W.

Planning

John Laurie Blvd N.W.

  • from Sarcee Trail N.W. to Shaganappi Tr N.W.

Planning

Sarcee Tr N.W.

  • from Country Hills Blvd N.W. to Stoney Tr Limit N.W.

Planning

Shaganappi Tr N.W.

  • from Kincora Gate N.W. to 144 Ave N.W.

Planning

Symons Valley Py N.W.

  • from 37 St N.W. to Kincora Gate N.W.

Planning

Southeast projects

Location Status

130 Ave S.E.

  • from Deerfoot Tr S.E. to Douglasdale Pt S.E.

Planning

146 Ave S.E.

  • from 104 St S.E. to Range Rd 285

Planning

36 St S.E.

  • from 17 Ave S.E. to Memorial Dr S.E.

In progress – Top lift paving in 2026

36 St S.E.

  • from Peigan Tr S.E. to 26 Ave S.E.

Planning

76 Ave S.E.

  • from Barlow Tr S.E. to 52 St S.E.

Planning

Anderson Road S.E.

  • from Macleod Trail S.E. to Deerfoot Trail S.E.

In progress – Top lift paving in 2026

Barlow Tr S.E.

  • from 90 Ave S.E. to 76 St S.E.

Planning

Bonaventure Dr S.E.

  • from Southland Dr SE to Willow Park Dr SE

Planning

Builders Rd S.E.

  • from 1 St S.E. limit to 50 Ave S.E.

Planning

Dover Ridge Dr S.E.

  • from 26 St S.E. to Dovercliffe Way S.E.

Planning

Manhattan Rd S.E.

  • from 42 Ave S.E. to 46 Ave S.E.

Planning

Southwest projects

Location Status

24 St S.W.

  • from 90 Ave S.W. to Glenmore Park

Planning

90 Ave S.W.

  • from 14 St S.W. to Oakmount Dr S.W.

Planning

Heritage Dr S.W.

  • from 14 St S.W. to Haddon Rd S.W.

Planning

Macleod Tr S.

  • from Fish Creek to Shawnessy Blvd S.E.

Planning

Shawnessy Blvd S.W.

  • from Shawnessy Dr S.W. to Macleod Tr S.

Planning

Shawnessy Dr S.W.

  • from Shawnessy Blvd S.W. to Shawnessy Blvd S.W.

Planning

Southland Dr S.W.

  • from Elbow Dr S.W. to Oakmoor Way S.W.

Planning

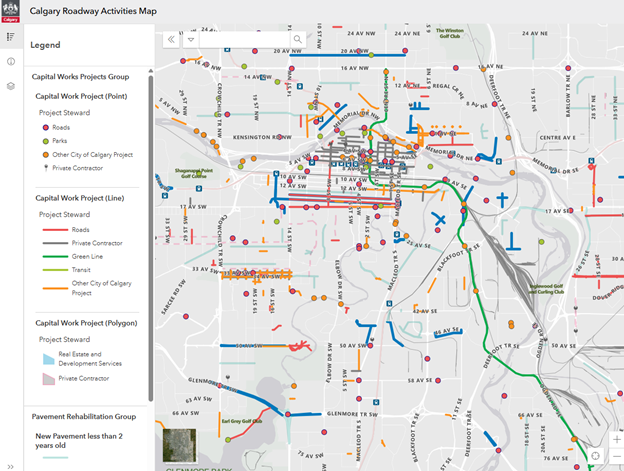

Calgary Roadway Activities Map

The Calgary Roadway Activities Map is a visual representation of road projects, such as paving. Click the link to discover what’s happening on Calgary’s transportation network!

Information for Contractors and Consultants

All road work must comply with Calgary’s Roads Construction Standard Specification.

Frequently Asked Questions (FAQ)

How will I be notified if paving work is scheduled in my neighbourhood?

Paving occurs not only on major routes, but in communities as well. If you live on a street where paving work will happen, project staff will connect with you prior to the start of the project to deliver information detailing the project impacts and provide contact information.

How does The City decide which roads to repave?

The City follows a multi-step process to objectively evaluate pavement quality and condition of Calgary’s road network and identify priorities for each paving season. The paving program is determined based on factors such as budget, upcoming infrastructure work (including utility repairs), and pavement quality.

Learn more about the Paving Programs processes in the road work brochure. All work complies with Calgary’s Roads Construction Standard Specifications.
